Storm & Hurricane

Rebuilding Stronger: Material Upgrades Worth Making

You are already paying for the access, the mobilization and the permit. That makes a rebuild the one moment when the upgrades that matter cost the least — here is which ones earn their place.

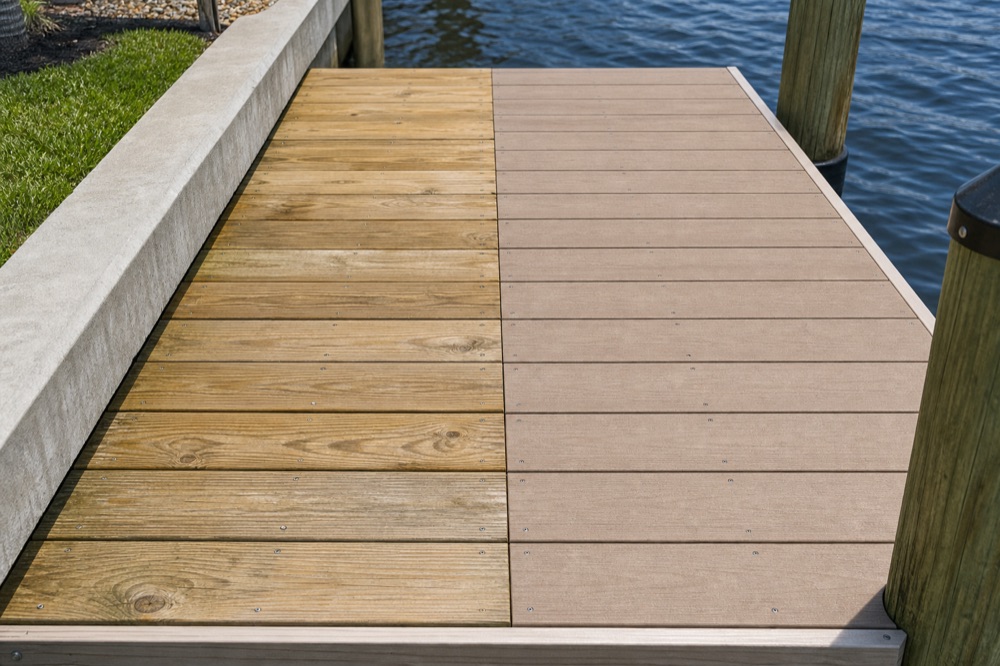

Close-up of a dock deck where weathered natural wood boards meet a newly laid section of gray composite decking, with the seawall edge and a piling at the edge of the frame

Key takeaways

  • A rebuild is the cheapest upgrade window you will ever get, because the access, the mobilization, the permit and the open framing are already paid for. The same upgrade bought separately later means paying for all of that a second time.
  • Rebuilding to exactly what was there is a default, not a decision. It is often the right answer — but it should be one you actually made.
  • Your own wreckage is the best specification document on the job. Walk it before it is hauled off and look at where it let go, because that is where the next storm will start.
  • Connections fail long before lumber does. Hardware specified as one compatible system, with cut ends and drilled holes treated as coating breaks, buys more real storm performance than almost anything else on the list.
  • Nothing on the water is hurricane-proof. The honest goal is fewer failure points, failures in cheaper places, and a structure that comes back in a shorter job.

There is a moment in every storm rebuild where somebody asks what it would take to put it back exactly as it was. It is a fair question, and often the answer is the right one. But “the same as before” is a default rather than a decision — and the moment you are standing in is the one moment when changing your mind is cheap.

That is the whole argument here. Not that you should gold-plate a dock: that upgrades made while a structure is open are bought at a fraction of what the same change costs later as its own project.

Why is a rebuild the cheapest time to upgrade?

Because the expensive part of marine work is rarely the material. It is getting there and getting in.

Mobilizing crew and equipment to your canal, staging on the lawn, working from the water where access demands it, permitting the job, opening the structure up — that is the bulk of what any dock or seawall project costs, and on a rebuild you pay it regardless. Better hardware, different decking, wrapped pilings, drainage put in properly behind a wall: each is a material and labor difference layered onto work that is happening anyway.

Buy the same upgrade separately later and you pay for the access, the mobilization and often the permitting a second time, for a much smaller piece of work. The order the job follows is covered in rebuild order after a storm — shoreline, pilings, deck, then power — and every phase has an upgrade decision inside it.

What does your own wreckage tell you?

More than any article can, including this one. Before the damaged material is hauled off, walk it.

You are looking for where it let go. Sound boards lying loose with the fasteners still in them says the connection failed, not the lumber. A bracket torn from one member while still bolted to the other says the same. Pilings that moved rather than broke point at the ground and the embedment. Decking that came off in sheets points at the fastening pattern. Corrosion concentrated at cut ends and drilled holes says the coating was interrupted and salt found the opening.

That is a specification nobody had to write. Whatever failed first is where the upgrade money goes, because the next storm starts in the same place.

Which upgrades earn their place while it is open?

The ones aimed at where things actually break. Roughly in the order we see them fail:

Where storms break things The upgrade while it is open The honest limit
Connections and fasteners Hardware specified as one compatible metal system, with cut ends and drilled holes treated as coating breaks Salt reaches everything eventually; connections you can inspect matter as much as their metal
The splash zone on pilings Wrapping, and a piling material chosen for the water rather than the line item Wrapping protects what it covers; above and below it still needs eyes
Decking after immersion Material and a fastening method that let one damaged board come out without dismantling a section No decking keeps a deck dry; this is about recovery, not immunity
Lift hardware Cables, sheaves, brackets, bunks and anodes replaced as a set rather than piecemeal A lift is only as good as the pilings holding it
The ground behind and beneath Drainage, working weep holes, backfill placed and compacted, rip-rap at the toe A seawall is not a flood barrier
Dock and lift power Dedicated, labeled circuits and a disconnect you can find in the dark Licensed electrician work, new and after any flooding

Piling wrapping targets the splash and tidal band, where wet-dry cycling, salt, sun and marine borers concentrate — the mechanism is in our guide to marine borers and piling wrapping. Decking is worth choosing on how it behaves wet and how easily one board comes out, not on how it photographs.

Design-time levers that exist mainly on a new build — deck elevation, thru-flow decking, embedment set for your site — belong to building for the next storm. On a rebuild some are still available to you, and it is worth asking which.

What about the ground rather than the structure?

It is the half that gets skipped, and where the slow failures live. Pilings sit in soil that storms rearrange.

Scour pulls material from the toe of a wall and from around pilings without announcing itself — the wall looks fine while the ground behind it quietly goes somewhere. Clogged weep holes trap water pressure behind a wall designed to release it. Backfill dumped rather than placed and compacted settles into a void you find later as a soft spot in the lawn.

A rebuild is the point at which all of it is reachable: drainage corrected, weep holes cleared, backfill done properly, and rip-rap placed at the toe where the wall needs protecting. None of it shows in a photograph of the finished dock, which is why it gets deferred.

So what does “stronger” actually mean?

Nothing on the water is hurricane-proof. Not ours, not anybody’s, and we do not use the word — and you should not accept a storm-performance claim that cannot be explained as a mechanism.

What these choices genuinely buy is a higher threshold before damage starts, fewer places for failure to begin, damage landing in the cheap replaceable parts instead of the framing and the pilings, and — the one owners feel most — a faster recovery. A dock that comes through needing decking replaced is a different phone call from one with pilings displaced and a wall undermined.

Florida Lifts & Docks has been on the water since 2008, licensed and insured, with our own crew rather than subcontractors and permitting handled in house. If you are rebuilding, we will lay these trade-offs against your site and put an itemized scope in your hands, free and on site. The full Storm Center covers the rest of the arc. See our custom docks page or call (239) 397-3400.

On the water since 2008Licensed & insured★ 5.0 on GoogleOwn local crew — never subbedServing 18 SW FL citiesFree on-site estimates
FAQ

Common questions.

Is it worth upgrading materials during a storm rebuild, or should I just replace what was there?

Replacing like for like is a legitimate choice, and sometimes it is the right one — but it should be a decision rather than a default. The reason to consider upgrading now is that the expensive part of any marine job is rarely the material itself. It is the access, the mobilization, the permitting and the labor of getting a structure open. All of that is already committed during a rebuild, so an upgrade made now is bought at a fraction of what the same change costs as its own project later on.

What fails first on a dock in a storm — the wood or the hardware?

Almost always the connections. Framing lumber and quality decking are rarely the weak link. What comes apart is where two pieces were joined: fasteners that lost their coating at a cut end or a drilled hole, brackets still bolted to one member and torn free of the other, and dissimilar metals in a wet connection that corroded faster than either metal would have alone. Specifying hardware as one compatible system, and putting connections where they can actually be inspected, is the highest-value change most rebuilds can make.

Does wrapping pilings actually help?

It protects the zone it covers, which is usually the zone doing the most damage. The splash and tidal band is where wet-dry cycling, salt, sun and marine borers concentrate their work, and a piling quietly losing section there is often the piece that gives first in a storm. Wrapping is not a force field: it protects what is under it, the material and installation quality matter, and everything above and below the wrap still needs looking at. It is a maintenance decision that behaves like a storm decision.

Should I use composite decking on a rebuild?

It is worth genuinely considering, and it is not automatic. What matters for storm performance is less the material name than how the deck behaves after immersion and how easily it can be repaired afterward — whether boards absorb and stay wet, whether the fastening method lets one damaged board come out without dismantling a section, and whether the fasteners themselves are compatible with the framing hardware. Everyday factors like heat underfoot, appearance and maintenance belong in the same decision, since you live with the dock on every day a storm is not happening.

Can you build a dock that survives any hurricane?

No, and we will not use the word hurricane-proof. Storms produce conditions beyond what any residential marine structure is designed for, and debris, current and water levels do not respect a specification. What upgrades buy you is a higher threshold before damage begins, fewer places for failure to start, damage concentrated in cheaper and more replaceable parts, and a rebuild afterward that is a repair job rather than a demolition. That is worth a great deal. It is not immunity, and anyone selling it as immunity is selling.
